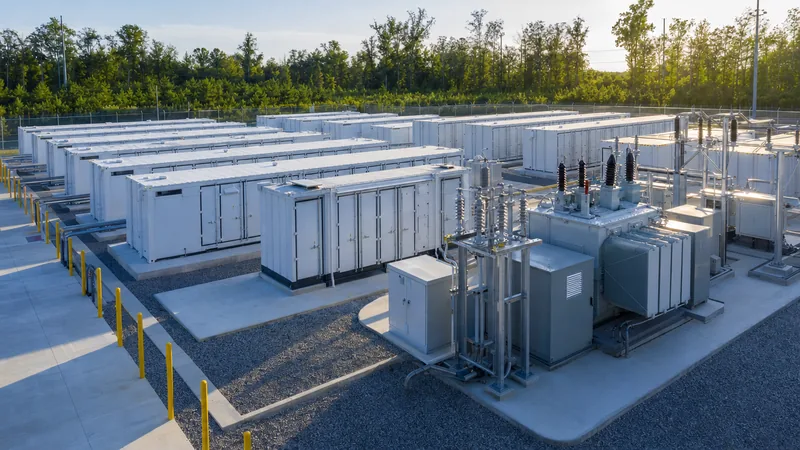

Key takeaways
- Successful battery storage projects require co-ordinated electrical design across DC battery strings, bi-directional power conversion systems, and medium-voltage step-up transformers.
- Selecting optimal bess locations demands strict adherence to NFPA 855 separation distances, structural load limits, and thermal dispersion requirements.
- Battery capacity sizing must account for cumulative degradation, operating depth of discharge, power conversion system efficiency, and transformer core losses over the operating life.
- Liquid-cooled battery enclosures reduce auxiliary thermal management energy consumption by 20% to 30% compared to conventional forced-air cooling designs.
- Commissioning protocols must validate islanding detection, primary frequency response, and fault ride-through per IEEE 1547-2018 and IEC 62933-5-2 standards.
Quick answer: Battery storage projects are utility-scale or commercial electrical installations that couple electrochemical energy storage with power conversion systems, transformers, and switchgear to deliver grid balancing, peak shaving, and energy arbitrage. Engineering these systems requires precise sizing, thermal management, protection co-ordination, and strict compliance with regional grid codes.
Deploying utility-scale and commercial battery storage projects involves far more than simply placing lithium iron phosphate (LFP) cell modules inside outdoor rated enclosures. Engineers, consultants, and procurement managers must integrate direct current (DC) electrochemistry with alternating current (AC) high-voltage distribution networks. This requires a balanced engineering approach covering fault level calculations, battery rack voltage matching, power factor management, and active fire mitigation.
As intermittent renewable generation increases across global networks, commercial energy storage systems have shifted from niche backup reserves to critical infrastructure assets. Successful execution relies on rigorous balance-of-plant (BOP) engineering, accurate lifecycle degradation modelling, and full compliance with international electrical standards such as IEC 62933, IEEE 1547, and NFPA 855.
System Architecture of Modern Battery Storage Projects
The core electrical architecture of modern battery storage projects is structured around two distinct operational domains: the DC battery island and the AC grid-tied power collection system. At the cell and module level, individual 3.2 V LFP cells are arranged in series-parallel configurations to form high-voltage DC racks, commonly operating between 1,000 V DC and 1,500 V DC to minimise ohmic losses ($I^2R$) along the main DC busbars.
The direct current feeds into a bi-directional power conversion system (PCS). In central inverter topologies, multiple 1,500 V DC battery racks connect in parallel to a shared DC bus before entering an inverter block rated between 1.0 MVA and 3.45 MVA. In string inverter configurations, distributed inverters handle smaller clusters of racks (typically 125 kW to 250 kW), which limits single-point failure risks and provides granular maximum power point tracking and state-of-charge balancing.
From the AC terminals of the PCS, output voltage typically ranges from 400 V to 690 V AC. A medium-voltage (MV) oil-immersed or dry-type step-up transformer elevates this to utility distribution levels, generally 11 kV, 22 kV, or 33 kV. Integrated within this MV skid is medium-voltage switchgear equipped with vacuum circuit breakers, protection relays, and revenue-grade metering that comply with IEC 62271-200. This multi-stage topology ensures safe fault clearing and seamless synchronisation with the local transmission or distribution network.
Evaluating Siting Criteria for BESS Locations
Selecting optimal bess locations requires resolving spatial, environmental, electrical, and regulatory requirements before civil works commence. Siting evaluations must balance proximity to the electrical point of common coupling (PCC) with statutory separation distances mandated by fire safety authorities.
Under NFPA 855 (Standard for the Installation of Stationary Energy Storage Systems, Table 4.4.2.1), outdoor pre-engineered modular containers must maintain a minimum physical clearance of 10 feet (3.05 metres) from lot lines, public ways, and adjacent buildings, alongside a minimum 3-foot (0.91-metre) separation between individual energy storage enclosures. If an installation lacks full-scale fire testing per UL 9540A, local jurisdictions often increase these separation margins significantly to prevent exterior thermal runaway propagation.
Beyond fire safety, structural engineers evaluating bess locations must analyse soil load-bearing capacities. A fully populated 20-foot liquid-cooled energy storage container weighs between 30 and 42 metric tonnes, generating high ground-bearing pressures that require reinforced concrete slab foundations or micropile designs. Ambient thermal characteristics also dictate siting feasibility; high ambient operating temperatures increase auxiliary heating, ventilation, and air conditioning (HVAC) loads, while coastal or industrial zones necessitate C4 or heavy-duty marine-grade anti-corrosion coatings compliant with ISO 12944.
Engineering Sizing Calculation: Sizing Commercial Battery Storage Projects
A worked engineering calculation demonstrates how nominal battery capacity must be uprated to meet delivered AC energy obligations at the end of system life. Consider a commercial project requiring an AC-delivered discharge capacity of 2,000 kW for a duration of 4.0 hours (8,000 kWh AC total delivered) at an MV point of connection, over a 10-year lifespan with a daily single-cycle regime.
The calculation accounts for component efficiencies, battery depth of discharge (DoD), and cell capacity fade over time:
- Required AC energy delivered to grid: $E_{AC} = 8,000\text{ kWh}$
- Medium-voltage step-up transformer efficiency: $\eta_{xfmr} = 98.8\%$ (0.988)
- Inverter / PCS round-trip discharge efficiency: $\eta_{PCS} = 98.5\%$ (0.985)
- DC balance-of-plant cabling efficiency: $\eta_{cable} = 99.2\%$ (0.992)
- Operational depth of discharge limit: $DoD = 90.0\%$ (0.900)
- End-of-life (EOL) battery capacity retention (after 10 years / 3,650 cycles): $SOH_{EOL} = 75.0\%$ (0.750)
First, calculate the usable DC energy required at Day 1 before accounting for battery degradation:
$$E_{DC,usable} = \frac{E_{AC}}{\eta_{xfmr} \times \eta_{PCS} \times \eta_{cable}} = \frac{8,000}{0.988 \times 0.985 \times 0.992} = \frac{8,000}{0.9654} = 8,286.7\text{ kWh}$$
Next, account for the 90% operating Depth of Discharge margin to prevent cell over-discharge:
$$E_{DC,operational} = \frac{8,286.7}{0.90} = 9,207.4\text{ kWh}$$
Finally, incorporate the 75% end-of-life degradation factor to determine the required Day-1 installed nameplate DC battery capacity without mid-life augmentation:
$$E_{DC,nameplate} = \frac{9,207.4}{0.75} = 12,276.5\text{ kWh} \approx 12.28\text{ MWh}$$
The engineering team must procure a nominal DC capacity of at least 12.28 MWh to guarantee the contractual 8.0 MWh AC delivery at Year 10. Alternatively, the project can be planned with an initial installation of 9.21 MWh DC coupled with an scheduled augmentation phase at Year 5, depending on levelised cost of storage (LCOS) economic optimisation.
Balance of Plant Comparison for Energy Storage Projects
Balance-of-plant selection dictates the efficiency, footprint, and maintenance overhead for large-scale energy storage projects. The two primary enclosure technologies deployed in commercial and utility-scale installations are forced-air convection enclosures and modular liquid-cooled enclosures.
As cell energy densities climb above 300 Ah per prismatic cell, internal heat generation demands tighter thermal gradients to avoid localised accelerated degradation. The following technical comparison highlights critical operational parameters across both approaches:
| Engineering Metric | Forced-Air Cooled System | Liquid-Cooled System | Impact on Project Operation |
|---|---|---|---|
| Cell Temperature Variance ($\Delta T$) | ≤ 5.0 °C | ≤ 2.5 °C | Liquid cooling extends overall battery cycle life by 15–20% |
| Auxiliary Parasitic Load (% of throughput) | 4.5% to 6.5% | 2.0% to 3.2% | Lower parasitic load directly improves overall project round-trip efficiency (RTE) |
| Energy Density ($kWh/m^2$ footprint) | 110 – 150 kWh/$m^2$ | 200 – 280 kWh/$m^2$ | Liquid cooling cuts required civil foundation area by up to 40% |
| Ingress Protection Rating | IP54 / NEMA 3R | IP65 / NEMA 4X (Core DC block) | Liquid cooling reduces particulate ingress in harsh environments |
| Thermal System Maintenance | Air filter cleaning every 3 months | Coolant changeout every 5 years | Lower site visitation frequency reduces scheduled operational expenditure |
| Step-up Transformer Coupling | External pad-mounted unit | Skid-integrated compact unit | Factory-assembled skids reduce on-site MV termination labour |
For high-throughput applications, such as frequency response and daily peak shaving, liquid-cooled architectures provide superior temperature uniformity. This maintains balanced cell internal resistance across all series strings, reducing premature thermal derating.
Step-by-Step Commissioning Protocol for Battery Storage Projects
Commissioning of battery storage projects follows an uncompromising sequence to verify insulation integrity, control system reliability, and network protection performance before commercial operation begins. Engineers must conduct testing in strict accordance with IEC 62933-2-1 and IEEE 2800 standards.
- Visual Inspection and Mechanical Torque Verification: Inspect all enclosures, check cable glands, and confirm bolt torque values on DC busbars and MV terminals using calibrated torque wrenches per manufacturer specification tables.
- Cold Insulation and Dielectric Testing: Perform DC insulation resistance tests (1,000 V megohmmeter) on all isolated power circuits and verify AC withstand dielectric strength on MV switchgear per IEC 60255.
- BMS and Thermal Loop Dry Run: Power auxiliary low-voltage panels without closing main DC contactors; verify that state-of-charge, voltage, and temperature sensor readings populate accurately across all Battery Management System (BMS) racks. Verify coolant pressures, flow rates, and leak sensor loops.
- Fire Suppression and Gas Detection Functionality: Mechanically trip and electrically verify aspiration smoke detection (VESDA), combustible gas sensors (measuring hydrogen and carbon monoxide concentrations), and aerosol or clean-agent release solenoids per NFPA 68 and NFPA 69.
- Inverter DC Pre-charge and Bus Energisation: Energise the PCS DC link using pre-charge resistors to prevent destructive inrush current to internal DC-link film capacitors before ramping up DC breaker closures.
- Hot Commissioning and Grid Compliance Validation: Close the main MV circuit breaker, verify system phase rotation, and conduct dynamic step-load tests to validate reactive power control (Volt-VAR), active power curtailment (Volt-Watt), and anti-islanding trip times within the 2.0-second threshold mandated by IEEE 1547-2018 Clause 8.1.
Next steps: specifying and sourcing
To obtain an accurate quotation for turnkey battery storage projects, your engineering package must define fundamental operating parameters: required AC usable capacity (MWh), continuous and peak inverter power ratings (MW), planned C-rate, point of common coupling voltage, local grid interconnection standards, and site-specific environmental ratings. Sharing single-line diagrams (SLDs) and anticipated duty cycles allows our application team to optimise your balance-of-plant setup.
Explore our integrated energy storage systems, high-efficiency liquid-cooled ESS containers, and factory-assembled prefabricated transformer substations. For project feasibility reviews, detailed balance-of-plant specifications, or factory-direct pricing, submit your requirements via our request a quote page or speak with our engineering desk through the contact page.
Frequently asked questions
What is the typical lifespan of commercial battery storage projects?
Commercial battery storage projects typically operate for 10 to 15 years, or between 4,000 and 8,000 full equivalent cycles, when using lithium iron phosphate (LFP) chemistry. Actual operating life depends heavily on operational C-rate, depth of discharge, ambient thermal conditions, and cell degradation rates over time.
How much space is required for a 1 MW / 2 MWh battery storage system?
A 1 MW / 2 MWh battery energy storage system typically requires a physical footprint of approximately 40 to 60 square metres for the equipment enclosure, plus required NFPA 855 fire separation clearances. Including access roadways and transformer clearance zones, a dedicated plot of roughly 150 to 250 square metres is standard.
What fire safety standards apply to battery storage projects?
The primary safety standards governing battery storage projects are NFPA 855 for stationary installation design, UL 9540 for complete energy storage systems and equipment, and UL 9540A for thermal runaway fire propagation testing. International projects must also comply with IEC 62933-5-2 electrical safety requirements.
What is the difference between AC-coupled and DC-coupled battery storage projects?
In an AC-coupled system, the battery storage array and solar generation utilize separate dedicated inverters that interface through a shared alternating current switchboard. In a DC-coupled system, both solar arrays and batteries share a common DC bus connected through a combined multi-port inverter, improving round-trip conversion efficiency.
Why is liquid cooling preferred over air cooling in large energy storage projects?
Liquid cooling provides significantly better thermal conductivity than air, maintaining cell temperature variance across large battery racks within 2.5 degrees Celsius. This precise thermal control reduces cell degradation rates, lowers parasitic cooling loads by up to 30 percent, and allows higher energy density inside shipping container enclosures.
