Transformers

Grid Integration of Renewable Energy Sources: Engineering Guide

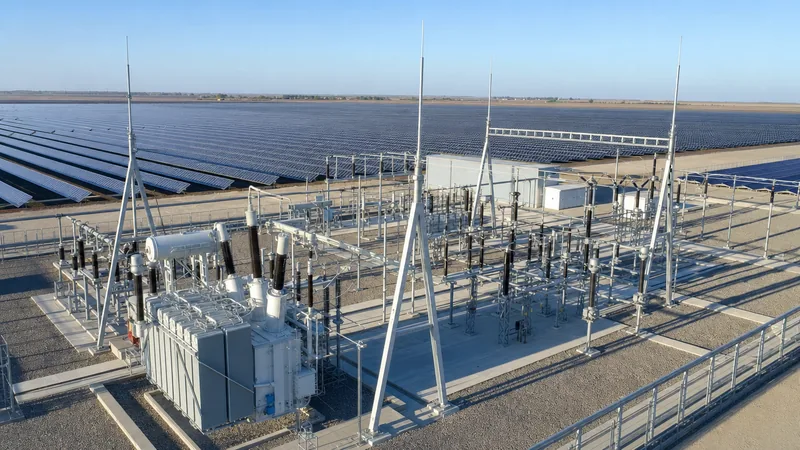

Substation transformer and switchgear for the grid integration of renewable energy sources

Key takeaways

  • Grid integration of renewable energy sources requires strict compliance with IEEE 1547-2018 and IEC 61727 to maintain power factor between 0.95 leading and 0.95 lagging under dynamic terminal conditions.
  • Inverter-based resources alter system fault physics by limiting short-circuit current to 1.1 to 1.5 per unit rated current, requiring specialised transformer protection settings and directional relaying.
  • Renewable step-up transformers must be rated for elevated harmonic loading, requiring a minimum K-factor of 4 to 9 or design under IEEE C57.110 to avoid thermal degradation of winding insulation.
  • Low-voltage ride-through standards require renewable generating plants to remain connected during balanced and unbalanced transmission faults with terminal voltage dips down to 0% for up to 150 ms.
  • Hybrid utility-scale installations pairing battery energy storage systems with solar PV dampen the primary frequency rate of change of frequency within 200 milliseconds to meet transmission system operator stability mandates.

Quick answer: The grid integration of renewable energy sources is the engineering process of safely and reliably connecting non-synchronous or variable generating plants—such as solar photovoltaic farms, wind plants, and battery storage facilities—into the wider alternating current electrical utility transmission or distribution network while upholding strict power quality, voltage stability, and system protection standards.

Integrating multi-megawatt renewable generation introduces fundamental physical challenges that distinguish modern networks from legacy utility architectures. Traditional generation assets rely on large, rotating synchronous machines that inherently provide rotational mechanical inertia and massive short-circuit current contributions during network faults. In contrast, solar photovoltaic (PV) arrays, battery energy storage systems (BESS), and Type 4 wind turbines interface with the medium-voltage (MV) or high-voltage (HV) electrical network through fast-acting power electronic inverters. This shift from synchronous generation to inverter-based resources (IBRs) fundamentally modifies system dynamics, system strength, and protective relay behaviour.

To successfully achieve interconnection, EPC contractors, system designers, and utility engineers must coordinate a broad spectrum of technical disciplines. These include specifying step-up transformers capable of handling high harmonic currents and dynamic DC bias, designing switchgear lineups able to isolate fast-acting converter faults, and deploying active voltage and frequency regulation apparatus. As modern utilities move toward higher penetration of sustainable resources, rigorous engineering design under standards like IEEE 1547-2018, IEC 60076, and regional grid codes dictates project commercial success and grid operational safety.

Core Challenges in Renewable Grid Integration and Power Quality

Power quality degradation remains one of the primary obstacles in renewable grid integration due to the inherent intermittency of wind and solar resources alongside the rapid switching frequencies of inverter topologies. When thousands of distributed semiconductor switches—typically Insulated Gate Bipolar Transistors (IGBTs)—synthesise a 50 Hz or 60 Hz sinusoidal voltage from a direct-current bus, they inherently introduce high-frequency switching ripple, voltage unbalance, and harmonic distortion into the medium-voltage collector system.

Transmission and distribution network operators require that total harmonic distortion for voltage (THDv) remains strictly below 5.0% at the point of common coupling (PCC) for systems between 1 kV and 69 kV, as defined by IEEE 519-2022 Table 1. Individual harmonic orders must not exceed defined thresholds (often under 3.0% for odd harmonics below the 11th order). In large-scale solar farms, central inverters or banks of string inverters can generate significant 5th, 7th, 11th, and 13th harmonic currents. If unmitigated, these harmonics enter step-up transformers and medium-voltage feeder cables, inducing stray load losses, circulating currents, and severe resonance with power factor correction capacitor banks.

Furthermore, rapid fluctuations in solar irradiance caused by fast-moving cloud formations cause sharp swings in real power output. This phenomenon, known as ramp rate volatility, creates secondary voltage fluctuations and rapid flicker on weak distribution networks. According to IEC 61000-4-15 standards, short-term flicker severity (Pst) must remain below 1.0, and long-term flicker severity (Plt) below 0.8 at the PCC. Managing these phenomena necessitates active reactive power control, coordinated shunt reactor banks, dynamic static synchronous compensators (STATCOMs), and smart inverters capable of volt-var control curves without relying solely on mechanical utility equipment.

Transformer Sizing and Selection for the Renewable Energy Grid

Sizing transformers for a renewable energy grid requires an entirely different engineering approach than sizing conventional industrial step-down units due to non-sinusoidal currents, reverse power flow, and continuous cyclic thermal loading. In photovoltaic and BESS applications, the inverter step-up (ISU) transformer operates under variable ambient temperatures during the day, elevated harmonic content from inverter modulation, and sustained periods at maximum nameplate capacity during peak generation hours.

Standard utility transformers are designed under the assumption of pure sinusoidal currents with a harmonic factor not exceeding 0.05 per unit. Applying this assumption to an inverter station will result in premature winding insulation failure. Engineers must calculate the transformer's stray load losses and eddy current losses under elevated harmonic spectrums using IEEE C57.110 recommendations. The rated eddy-current loss increases proportionally to the square of the harmonic order multiplied by the harmonic current magnitude. Consequently, specifying a K-factor rating (typically K-4 to K-9 for central inverters) or explicitly demanding electrostatic shielding between the low-voltage (LV) and medium-voltage (MV) windings is critical to decouple high-frequency common-mode noise and protect the primary grid.

Careful evaluation of the transformer cooling methodology is equally vital. While forced air systems increase maximum output, selecting the correct cooling class—such as an ONAF transformer cooling arrangement—ensures that the core and coils do not exceed standard temperature rises of 65°C over a 30°C ambient average when full solar irradiation coincides with maximum summer ambient temperatures. Additionally, selecting between oil-immersed units and high-capacity cast-resin dry designs depends on site environmental constraints. In environmentally sensitive catchment basins, dry units or ester-filled liquid units prevent hazardous spill liabilities. Engineers must evaluate standard configurations using comprehensive sizing methods such as the kVA calculator substation sizing guide to ensure continuous, derating-free operation over a 30-year design life.

Harmonic Derating and Thermal Sizing Calculation for Inverter Transformers

A structured calculation ensures that an inverter step-up transformer possesses sufficient thermal margin to prevent premature dielectric degradation from harmonic losses. Standard winding temperature rise limits defined in IEC 60076-2 (typically 65 K for standard mineral oil) assume pure 50 Hz or 60 Hz currents. Inverter switching injects high-frequency currents that multiply winding eddy current losses (P_EC) and other stray losses (P_OSL).

To calculate the required transformer capacity derating or evaluate the Harmonic Loss Factor (F_HL) per IEEE C57.110, engineers evaluate the individual harmonic current spectrum delivered by the solar inverter manufacturer. Consider a concrete 2,500 kVA, 0.69 kV to 33 kV step-up transformer operating on a central PV inverter with the following measured harmonic spectrum at full load:

  • Fundamental (h = 1): 100% (1.000 pu)
  • 5th harmonic (h = 5): 4.0% (0.040 pu)
  • 7th harmonic (h = 7): 3.0% (0.030 pu)
  • 11th harmonic (h = 11): 1.5% (0.015 pu)
  • 13th harmonic (h = 13): 1.0% (0.010 pu)

The standard baseline losses for this 2,500 kVA unit are determined from factory routine test reports: No-load loss (P_0) = 2,400 W; Base DC I²R loss (P_dc) = 18,500 W; Baseline winding eddy-current loss (P_EC-R) = 2,200 W (which represents 11.9% of DC loss); Baseline other stray loss (P_OSL-R) = 1,100 W.

Step 1: Calculate the Harmonic Loss Factor for winding eddy currents using the standard summation formula:

F_HL = [ Σ (I_h / I_1)² × h² ] / [ Σ (I_h / I_1)² ]

The denominator represents the square of the total RMS current in per-unit terms:

Σ (I_h / I_1)² = 1.000² + 0.040² + 0.030² + 0.015² + 0.010² = 1 + 0.0016 + 0.0009 + 0.000225 + 0.0001 = 1.002825

The numerator represents the frequency-weighted harmonic square summation:

Numerator = (1.000² × 1²) + (0.040² × 5²) + (0.030² × 7²) + (0.015² × 11²) + (0.010² × 13²)

Numerator = 1.000 + (0.0016 × 25) + (0.0009 × 49) + (0.000225 × 121) + (0.0001 × 169)

Numerator = 1.000 + 0.0400 + 0.0441 + 0.0272 + 0.0169 = 1.1282

F_HL = 1.1282 / 1.002825 = 1.125

Step 2: Calculate the modified winding eddy current loss under non-sinusoidal loading:

P_EC = P_EC-R × F_HL = 2,200 W × 1.125 = 2,475 W

This represents a 275 W increase directly inside the winding copper conductors. Step 3: Determine the maximum permissible loading factor (I_max pu) to maintain standard thermal rise:

I_max (pu) = √ [ (P_dc + P_EC-R) / (P_dc + (F_HL × P_EC-R)) ]

I_max (pu) = √ [ (18,500 + 2,200) / (18,500 + 2,475) ] = √ [ 20,700 / 20,975 ] = √ 0.9869 = 0.9934 pu

To deliver full 2,500 kVA inverter output continuously without exceeding temperature rise thresholds, the required nameplate rating must be adjusted:

Required Rating = 2,500 kVA / 0.9934 = 2,516.6 kVA

Therefore, a standard 2,500 kVA core and coil design must be specified as a minimum 2,600 kVA standard thermal frame or ordered with custom winding conductors to ensure the hot-spot temperature rise does not exceed the IEEE C57.12.00 Table 5 limit of 80 K over ambient.

Grid Connection of Renewable Energy Sources: Voltage and Frequency Regulation

Executing the grid connection of renewable energy sources demands active apparatus and closed-loop control schemes that can stabilize the PCC voltage and line frequency within precise statutory envelopes. Historically, distribution utilities regulated voltage passively along radial lines using substation bus regulation, line drop compensators, and mechanical switched capacitor banks. When large renewable energy plants inject variable active power into distribution feeders, they can cause reverse power flow and overvoltage conditions at the feeder extremities.

Modern utility interconnection standards, specifically IEEE 1547-2018 Clause 5, mandate that inverter-interfaced generating assets actively participate in voltage regulation. Inverters are required to support four standard reactive control modes:

  1. Volt-Var Mode: The inverter automatically adjusts reactive power output (Q) in response to local terminal voltage (V) variations along an adjustable piecewise linear curve.
  2. Constant Power Factor Mode: The plant maintains a fixed power factor setpoint commanded by the utility Supervisory Control and Data Acquisition (SCADA) system, typically adjustable between 0.90 leading (absorbing) and 0.90 lagging (injecting).
  3. Volt-Watt Mode: When line voltages reach elevated operational limits (typically 1.06 to 1.10 pu), the plant curtails active power (P) output to prevent exceeding statutory overvoltage tripping levels.
  4. Constant Reactive Power Mode: The plant injects or absorbs an absolute quantity of megavars regardless of system voltage, supporting regional transmission system operator (TSO) grid balance.

To support steady-state voltage matching across seasonal transmission shifts, large renewable substations incorporate an on-load tap changer within the main substation power transformer. Using robust mechanical or vacuum diverter mechanisms, detailed in the load tap changer engineering guide, the step-up transformer adjusts its primary-to-secondary turns ratio under load without interrupting power delivery, compensating for transmission grid drift while keeping the internal 33 kV collector bus at nominal voltage.

Fault Ride-Through and Protection in a Green Energy Grid

Fault ride-through capabilities and specialised protection schemes are mandatory requirements for assets operating on a green energy grid to prevent localized transmission disturbances from causing catastrophic cascading blackouts. Prior to the wide deployment of grid codes such as Germany's VDE-AR-N 4110 or the US FERC Order 661-A, renewable inverters were programmed to trip offline instantaneously upon detecting any voltage disturbance. In modern systems, this rapid disconnection threatens system security by removing hundreds of megawatts of active generation during transmission line faults.

Today, grid codes dictate strict Low-Voltage Ride-Through (LVRT) and High-Voltage Ride-Through (HVRT) envelopes. Under standard LVRT requirements, an interconnected plant must remain online when the voltage at the PCC drops to 0% of nominal voltage for up to 150 milliseconds, followed by a linear recovery trajectory back to 90% of nominal voltage over a period of 1.5 to 3.0 seconds. Furthermore, during this depression, the inverter controls must inject fast reactive fault current (k-factor reactive current injection) within 20 milliseconds to help the utility system restore line voltage and trigger electromechanical protection relays.

However, the fault behaviour of IBRs creates significant hurdles for classic protective relaying. Unlike synchronous generators that supply 5 to 8 times their rated current during a three-phase bolted short circuit, modern inverters are thermally limited by their power electronic silicon switches to between 1.1 and 1.5 times full-load current (FLC). This severely diminished fault signature makes traditional overcurrent relays (ANSI device 51) insensitive to network faults on the collector system. Relaying engineers must therefore implement specialized line differential protection (87L), transformer differential schemes (87T), and negative-sequence directional overcurrent elements (67N) to ensure rapid, dependable fault clearance, as outlined in detailed transformer protection engineering designs.

Switchgear and Substation Architecture for Variable Generation

The balance-of-plant architecture for renewable collector systems requires durable, flexible switchgear and modular substation engineering designed for frequent switching cycles and aggressive environmental conditions. A utility-scale 100 MW solar or wind plant typically uses a medium-voltage collector topology operating at 33 kV or 34.5 kV, routing power from multiple dispersed inverter skid transformers back to a centralized project substation.

Substation and collector circuit switchgear must handle specific stress profiles. Vacuum circuit breakers (VCBs) are preferred for collector feeder isolation due to their high mechanical endurance (typically 10,000 to 30,000 operations under normal load) and their ability to withstand the transient recovery voltages (TRVs) caused by switching long underground cable runs. Cable circuits in renewable arrays have significant shunt capacitance; de-energizing these long feeder cables generates high capacitive inrush and restrike risks across breaker contacts, making standard C2-class capacitive switching certification under IEC 62271-100 mandatory.

Engineers evaluate primary equipment options based on site-specific physical parameters, lifecycle requirements, and footprint limitations. The following decision matrix provides engineering teams with definitive selection criteria between standard switchgear configurations deployed in modern renewable substations:

Feature / ParameterAir-Insulated Switchgear (AIS)Gas-Insulated Switchgear (GIS)Solid-Insulated Switchgear (SIS)
Applicable StandardIEC 62271-200 / IEEE C37.20.2IEC 62271-203 / IEEE C37.122IEC 62271-200
Dielectric MediumAtmospheric AirSulfur Hexafluoride (SF6) or Alternative GasEpoxy Resin / Solid Polymer
Footprint Relative to AIS100% (Baseline)25% to 35%40% to 50%
Environmental SensitivityHigh (dust, humidity, coastal salt)Negligible (hermetically sealed)Low (encapsulated poles)
Internal Arc Classification (IAC)AFLR up to 40 kA / 1 sAFLR up to 40 kA / 1 sAFLR up to 25 kA / 1 s
Target ApplicationInland solar farms, arid environmentsOffshore wind, coastal PV, compact sitesStandard commercial solar & distributed BESS
Maintenance Interval3 to 5 years (contact cleaning/greasing)10 to 15 years (gas pressure monitoring)5 to 8 years (visual and torque check)

Renewable Energy Integration Smart Grid: Storage and Inertia Solutions

Advancing renewable energy integration smart grid strategies requires deploying complementary assets capable of replacing the physical rotational inertia and dispatchable reserves lost when closing fossil-fired generation plants. As system non-synchronous penetration (SNSP) climbs above 60% to 75% on regional grids, transmission operators face rapid increases in the Rate of Change of Frequency (RoCoF) following a generation trip, potentially triggering under-frequency load shedding (UFLS) relays before standard turbine-governors can respond.

To solve this fundamental physical vulnerability, utilities and independent power producers (IPPs) are integrating utility-scale battery energy storage systems and synchronous condensers into their transmission architecture. Modern grid-forming (GFM) inverters are programmed to act as instantaneous voltage sources behind a virtual impedance, contrasting with conventional grid-following (GFL) inverters that merely synchronize to an existing grid voltage vector via a phase-locked loop (PLL). GFM inverters provide true "synthetic inertia" by immediately injecting or absorbing power within milliseconds of a frequency deviation, dampening RoCoF without mechanical wear.

Large synchronous condensers—de-energized synchronous motors floating on the transmission bus with no mechanical load—provide both real physical inertia (H-constant) and high short-circuit capability (MVA) directly to the PCC. This dramatically improves the system's Short Circuit Ratio (SCR). While high-voltage grids typically operate with an SCR well above 3.0, remote renewable collection zones often exhibit weak-grid characteristics with an SCR below 1.5. Integrating synchronous condensers or grid-forming BESS allows conventional inverters to remain stable, suppresses harmonic resonances, and ensures directional protective relays can reliably clear system faults.

Factory Testing and Commissioning Checklist for Grid Interconnection

A structured quality assurance and factory acceptance testing (FAT) program ensures that electrical apparatus destined for renewable collector substations meets strict interconnection parameters before transport to site. Equipment failure during field commissioning creates severe project delays, liquidated damages, and contractual grid compliance disputes with system operators.

Electrical project engineers and procurement teams should integrate the following inspection and testing checklist into their Requests for Quotation (RFQs) and quality plans for all main step-up power transformers and collector switchgear:

  1. Dielectric Routine Testing (IEC 60076-3): Verify that power transformers undergo separate source AC withstand voltage tests and induced AC withstand voltage tests (IVW) with online Partial Discharge (PD) measurement. Acceptance limit: PD level must remain below 100 pC at 1.58 Um / √3.
  2. Frequency Response Analysis (FRA): Perform sweep frequency response analysis (SFRA) per IEC 60076-18 across the 20 Hz to 2 MHz spectrum before and after factory short-circuit testing to establish an unalterable mechanical baseline for transit damage assessment.
  3. Harmonic Temperature Rise Verification: Review the certified heat run test (temperature-rise test per IEC 60076-2) adjusted specifically for the customer-specified harmonic spectrum and calculated eddy losses (F_HL factor).
  4. Bushing Power Factor and Capacitance: Measure the C1 and C2 dielectric dissipation factor (tan δ) and capacitance of all MV and HV condenser bushings per IEEE C57.19.01; dissipation factor must not exceed 0.5% at 20°C.
  5. Switchgear Mechanical and Arc Resistance Verification: Confirm that MV switchgear holds valid Type Test Certificates for Internal Arc Classification (IAC AFLR) per IEC 62271-200 for 31.5 kA or 40 kA at a 1.0-second duration, alongside mechanical endurance testing to Class M2.
  6. Inverter-Transformer Core Grounding Verification: Verify the presence of an externally accessible, single-point removable core-and-frame ground link inside a dedicated terminal enclosure to permit straightforward un-grounded megohmmeter insulation checks during annual field maintenance.

Next steps: specifying and sourcing

Successful execution of utility-scale renewable generation and storage assets depends heavily on specifying robust, grid-code-compliant primary equipment tailored to the unique electrical and thermal stresses of inverter collector networks. To initiate your project sizing or obtain an engineering review, provide our design team with your single-line diagram (SLD), point of common coupling voltage, target harmonic spectrum, short-circuit current availability, and site ambient limits.

Explore our engineering capabilities across our utility-grade power transformer solutions, pad-mounted collector skids, and factory-integrated transformer substation designs. For complete technical support, design optimization, and formal tenders, visit our quotation inquiry page or speak directly with an application engineer via our contact page.

Frequently asked questions

What is grid integration of renewable energy sources?

Grid integration of renewable energy sources is the technical process of connecting renewable power generation—such as wind farms, solar PV arrays, and battery storage—into the electrical utility grid while preserving voltage stability, frequency regulation, and power quality standards.

Why do renewable inverters cause power quality issues?

Renewable inverters generate power quality issues primarily due to high-frequency harmonic injection from IGBT switching and rapid active power fluctuations from variable environmental conditions like moving clouds or changing wind speeds, leading to voltage flicker.

What is Low-Voltage Ride-Through (LVRT)?

Low-Voltage Ride-Through is a grid code requirement forcing renewable generation plants to remain connected and operating during severe network voltage dips, such as transmission line short circuits, rather than tripping offline and exacerbating grid collapse.

How does an inverter step-up transformer differ from a standard transformer?

An inverter step-up transformer is engineered to endure elevated harmonic currents without overheating, withstand high dv/dt voltage stresses from inverter switching, manage DC bias currents, and operate under continuous, cyclic full-capacity solar or wind loading.

What is the role of battery storage in renewable grid integration?

Battery storage smooths out variable renewable generation ramps, provides synthetic inertia and primary frequency response via grid-forming inverters within milliseconds, and absorbs peak power to prevent distribution feeder overvoltage and thermal congestion.
